The Pāpāmoa East Interchange

Construction of a new interchange over the Tauranga Eastern Link will see Pāpāmoa East connected to the motorway and enable further development of the area.

Pāpāmoa East Interchange construction

Tauranga is growing and changing fast. The coastal fringe is expected to grow significantly over the next 40 years, reaching up to 30,000 people by 2060. This includes more people and more traffic to get people to where they want to go.

We are committed to developing ‘liveable communities’ that ensure people are optimally connected to the places they live, learn, work and play.

To unlock development at Pāpāmoa East and allow further growth at Golden Sands and Wairākei, we will be constructing a new interchange at the eastern end of Te Okuroa Drive, to provide access to the motorway.

This interchange will enable faster travel between neighbourhoods in Pāpāmoa East and Tauranga city centre, Mount Maunganui and Te Puke for people choosing to travel by car. It will also provide a connection to the Rangiuru Business Park once that is operational.

The intersection will be constructed across the Tauranga Eastern Link Toll Road/State Highway 2 (SH2), east of the Wairākei neighbourhood, linking Te Okuroa Drive and future The Sands Avenue. Earthworks to prepare for construction start in mid-July 2022 and the interchange is scheduled to be ready for use mid 2026. This work will have some impacts on traffic on the TEL TR – reduced speed and lane closures will apply when necessary to keep drivers and construction crew safe.

Artists impression of the new Pāpāmoa East Interchange

Why is this important?

Over the past few years, development in Pāpāmoa East has increased pressure on Tara Road as the main connection to SH2. This project will provide residents in the area with an alternative route and enable further development in Pāpāmoa East which helps support Tauranga’s growth. The Pāpāmoa East Interchange will ensure the community is connected to opportunities to live and work within parameters as defined by Smartgrowth’s UFTI.

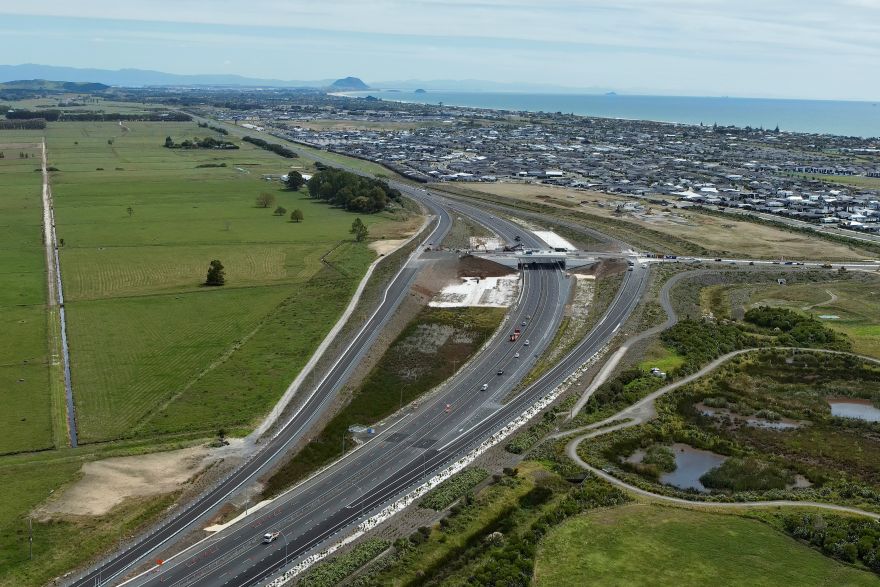

Local students check out Pāpāmoa East Interchange progress

20 primary school students from Golden Sands School were thrilled to take a peak behind the scenes at the Pāpāmoa East Interchange work site in November. Here they learnt about construction and site safety, and some were lucky enough to take a seat in some of the construction machinery. Organised by TCC and hosted by HEB Construction who are responsible for Phase 2 of the work, it was a great day out for the students, parents and teachers. Great to see young engineering minds being inspired!

Read more about local students check out Pāpāmoa East Interchange progress.

hildren from Golden Sands School were thrilled to take a peak behind the scenes at the Pāpāmoa East Interchange work site last week.

Partners

This project is a collaboration between Tauranga City Council and Waka Kotahi NZ Transport Agency with support from Bay of Plenty Regional Council and Western Bay of Plenty District Council. The work is guided by designers Bloxam Burnett & Olliver (BBO) and construction is in the hands of HEB Construction Ltd.

We are also working with our iwi partners Te Kapu o Waitaha, Tapuika Iwi Authority, Ngā Pōtiki a Tamapahore Trust and Te Rununga o Ngāti Whakaue ki Maketū. This partnership includes capturing and documenting stories from tangata whenua that relate to the area and its history and cultural monitoring during the early phases of earth works.

Construction stages

As some of the construction site is on farmland, which was part of the Kaituna wetlands, we need to allow nine months for earthworks settlement. This work started in July 2022. Construction of the interchange itself is likely to commence in late-2023 and conclude early 2026.

Stage 1

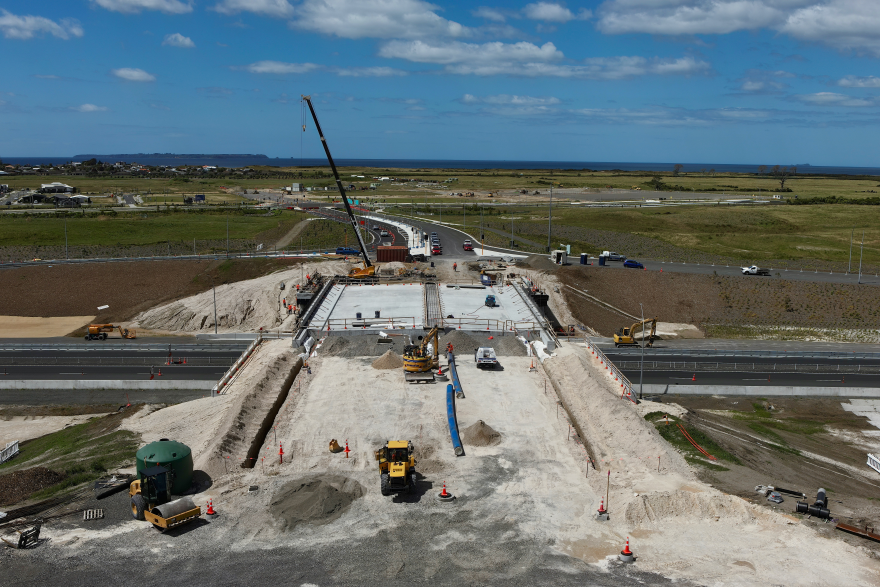

Earth works have now been completed. This phase included:

  • A nine metre high embankment – forming the westbound (Tauranga) exit and entry ramps of the interchange
  • Installing three culverts, including one under the Tauranga Eastern Link, and culvert extensions
  • Installing flexible safety barriers and widening the southern side of Tauranga Eastern Link
  • Earthworks to build a stormwater retention pond, swales and connecting drains

Stage 2

Te Okuroa Drive extension – in progress, anticipated to conclude late 2023

This phase of the project includes construction of the extension of Te Okuroa Drive and the intersection with future The Sands Avenue. This phase is scheduled to finish at the end of 2023 and includes:

  • The Te Okuroa and The Sands Avenue signalized intersection
  • Te Okuroa Drive 4 lanes continuation (east) to intersection
  • The works includes shared bi-directional cycleway, footpaths, traffic islands/refuges, stormwater, street lighting, traffic signals and utilities.
  • Trunk water main to service Wairākei and Te Tumu
  • Stormwater reticulation and culverts facilitating improved drainage.
  • Wastewater trunk main to service Te Tumu
  • CCTV cameras and associated fibre cable/ducting

During this phase of work a section of the cycle track alongside the Tauranga Eastern Link will be diverted via a purpose-built temporary track.

Stage 3

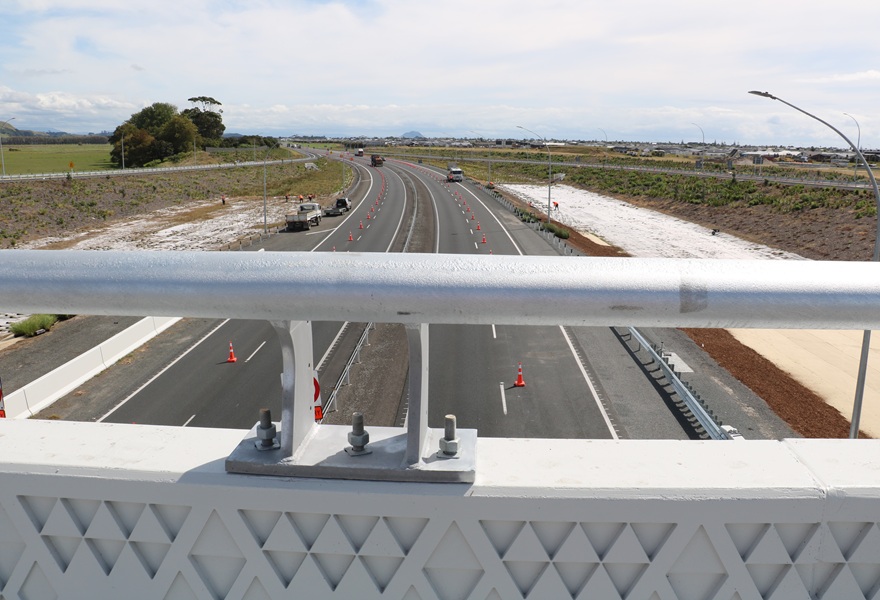

Pāpāmoa East Interchange and The Sands Avenue construction - leading north to the intersection with Te Okuroa Drive. Construction for the interchange itself is scheduled to start late 2023 and go conclude mid 2026. We are expecting to award the contract for this phase shortly and once that’s done will be able to share more details on the construction plan and anticipated impacts on traffic on the Tauranga Eastern Link Toll Road.

Location

The intersection will be constructed over the Tauranga Eastern Link Toll Road (SH2), east of Wairākei neighbourhood, linking Te Okuroa Drive and future Sands Avenue.

Map of The Pāpāmoa East Interchange location

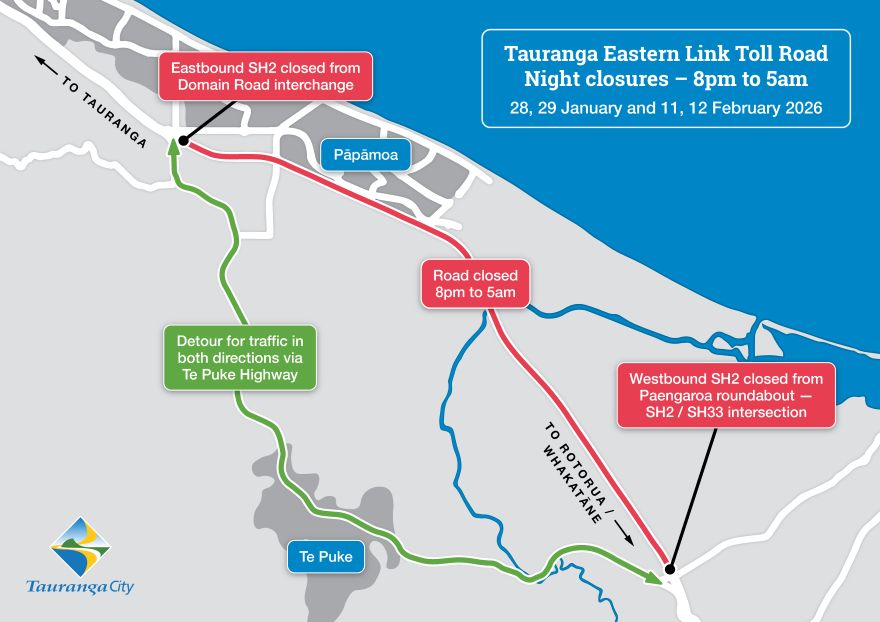

Traffic impacts on the Tauranga Eastern Link

With the conclusion of preliminary earth works, traffic management on the Tauranga Eastern Link Toll Road (TEL TR)/State Highway 2 has now been removed. For now, no traffic management will be required until construction of the interchange itself commences in early 2024. We’ll be able to share details on what traffic management to support this phase of construction will look like closer to the time.

Common questions

The Pāpāmoa East Interchange is a full diamond intersection, providing access to the Tauranga Eastern Link from the neighbourhoods at Pāpāmoa East which improves connections for these communities with Tauranga CBD, Mount Maunganui and Te Puke as well as the wider region.

Construction of the Pāpāmoa East Interchange will be constructed in three phases. The start of earthworks is scheduled for early July, which will be executed by our contractor HEB Construction limited. Earthworks are necessary to ensure a stable foundation on land that is currently very boggy.

Once earthworks and preparatory works are concluded, the next phase will see the construction of an extension to Te Okuroa Drive, with the final phase finishing the construction of the interchange and building a connection between Sands Avenue and Te Okuroa Drive. We expect the interchange to open early 2026.

We want to ensure communities out east are connected to opportunities for work and play at less than 45 minutes from home. The new interchange will provide increased capacity and connectivity to support the traffic demands associated with the development of Pāpāmoa East.

New Zealand’s population is growing and we are experiencing a nationwide shortage in housing. The government is asking Tauranga City Council to enable the construction of 11,000 homes to accommodate population growth. To facilitate this development, Tauranga City Council have received funding for the Pāpāmoa East Interchange through the Housing Infrastructure Fund.

Approximately 51% of the costs of the project will be funded by Waka Kotahi. The remaining costs will be funded via development contributions from both the Wairakei and the future Te Tumu growth areas.

TCC has received a 10 year interest free loan for the project via the Housing Infrastructure Fund (HIF) . The HIF loan does not directly fund the project but it reduces the debt costs faced by TCC given that development contributions can only be recouped as land development occurs.

Key information

Project type
Transport and movement

Status
Underway

Neighbourhood
Papamoa / Papamoa East

Key dates

  • Phase 1 - Earth works

    July 2022 to July 2023
  • Phase 2 - Te Okuroa Drive extension

    June 2023 to early 2024
  • Phase 3 - Pāpāmoa East Interchange and Sands Avenue construction

    Late 2023 to mid 2026

Who's listening

Transport Team
Tauranga City Council

Email: PEIProject@tauranga.govt.nz
Phone: 07 577 7000

Other ways to get involved
